Machine Utilization & Capacity Planning

Profitable capacity planning starts with one discipline: measuring machine time categories accurately before making staffing or capital decisions.

Run the Numbers Instantly

Our ROI & Capacity Calculator models utilization scenarios, shift patterns, and automation impact in real time.

Open Capacity Calculator
ROI and OEE modelPlanning assumptions tied to measured shop dataScenario InputsMeasured Run-StateInvestment CaseScenario outputs should be checked against measured utilization and finance assumptions.

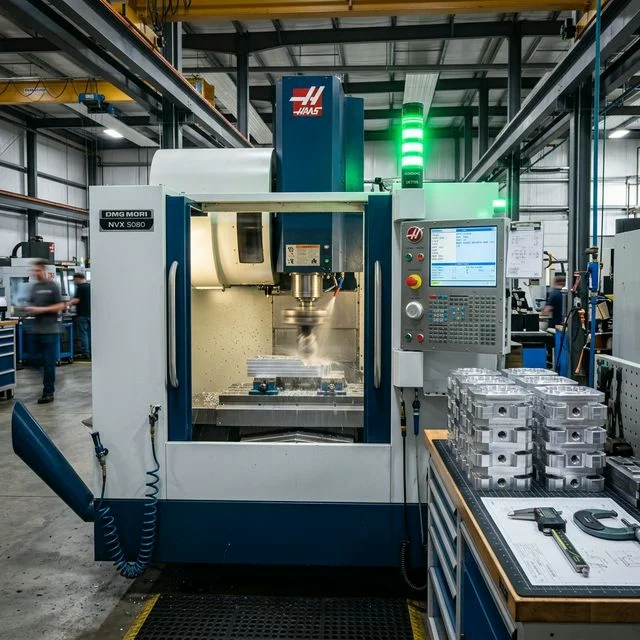

Green light running — this VMC is actively cutting parts with completed aluminum components stacked on the inspection table. Every idle minute is lost revenue.

Machine Utilization Formula

Utilization (%) = (Actual Production Hours / Available Hours) × 100

Time Categories to Tag Correctly

  • Run Time: spindle engaged in value-producing cutting cycles
  • Setup Time: fixture, program, and tool preparation between jobs
  • Support Time: loading, unloading, in-process checks, material handling
  • Planned Stop: scheduled maintenance, changeover windows, planned cleaning
  • Unplanned Stop: faults, waiting, tool breakage, material shortages

What Counts as "Available Hours"

  • 1 shift: 8 hrs × 250 days = 2,000 hrs/yr
  • 2 shifts: 16 hrs × 250 days = 4,000 hrs/yr
  • 3 shifts: 24 hrs × 365 days = 8,760 hrs/yr
  • • Subtract planned maintenance windows
  • • Subtract holidays / shutdown weeks

Utilization vs OEE: Know the Difference

Utilization tells you how much time the machine runs. OEE tells you how well it runs during that time.

MetricFormulaAnswersInterpretation
UtilizationRun hrs / Available hrs"Is the machine on?"Runtime share only
OEEAvail × Perf × Quality"Is it making good parts fast?"Quality and speed adjusted

A machine can have 90% utilization but only 50% OEE — it's running all day, but slowly, with scrap. For the full breakdown, see our OEE Guide.

Utilization Planning Profiles

Operating ProfilePrimary ConstraintPlanning FocusRequired Data
Job Shop (High Mix)Frequent setup and schedule changesReduce setup variance and queue timeSetup logs by part family and shift
Production ShopBottleneck concentration and maintenance windowsStabilize cycle adherence and preventive maintenance executionCycle-time variance and downtime reason codes
Automated CellUnattended reliability and fault recoveryQualify stable part families before extending unattended hoursAlarm frequency, restart success, and first-pass yield

Capacity Planning: Do You Need Another Machine?

The most expensive mistake in manufacturing is buying a machine you don't need — and the second most expensive is not buying one when you do.

Required Capacity (hrs) = Σ (Part Qty × Cycle Time) / OEE Factor
1

Sum your demand

Total up all jobs for the planning period (week/month/quarter). Include setup time and secondary operations.

2

Apply OEE factor

Divide total demand hours by your measured trailing OEE for the relevant machine group. This gives you the actual hours needed.

3

Compare to available capacity

If required > available, your options are: add shifts, add machines, outsource, or improve OEE.

Capacity Buffer Rule:

Plan an explicit reserve buffer for rush jobs, rework, and unplanned downtime. In stable environments this buffer can be smaller; in volatile high-mix work it should be larger.

5 Quick Wins to Boost Utilization

1. Reduce Setup Time (SMED)

Convert internal setup to external. Pre-stage tools, fixtures, and programs before the current job finishes.

Track setup variance reduction by part family and shift

2. Batch Similar Jobs

Group parts with same tooling/material to minimize changeovers. Run all 6061 Aluminum jobs in one block.

Measure queue-time and setup-frequency impact monthly

3. Stagger Operator Breaks

Don't stop all machines for lunch. Stagger breaks so at least 50% of machines are always running.

Validate by comparing pre/post run-state continuity

4. Adopt Predictive Maintenance

Vibration monitoring prevents surprise breakdowns. Schedule maintenance during low-demand windows.

Track alarm trend, downtime minutes, and recovery speed

5. Lights-Out Manufacturing

Run unattended overnight with pallet systems, bar feeders, or robot loading after process stability is validated. On an 8-hour baseline shift, an additional 4 unattended hours increases available machine time by 50%.

Model unattended hours as a separate, risk-adjusted scenario
